Panel Upgrades · August 21, 2026

Electrical Panel Upgrade Cost in Portland & Vancouver, WA (2026 Guide)

New 200-amp residential electrical panel with labeled breakers installed by Power Professor in the Portland area

Short answer: with us in 2026, replacing an electrical panel costs $2,800 to $3,200, and replacing the panel and upgrading the service from 100 to 200 amps, with new service wires and a new meter socket, costs $5,100 to $6,800. Moving the panel to a new spot starts around $7,700, and a 400-amp service for a large home or shop runs $7,000 to $12,000 and up. The permit and inspection are included in every one of those numbers.

Those are our current prices for the Portland metro and Clark County, not a national cost calculator that averages in Kansas City. Every house is a little different, so below is exactly what moves a quote up or down, what the permit actually costs on each side of the Columbia, how PGE and Clark Public Utilities fit into the schedule, and how long the whole thing takes from first call to final inspection.

If you already know your panel is a problem (warm to the touch, breakers that trip, a Federal Pacific or Zinsco label), skip to our prices and then request a written estimate. If you're still deciding whether you need an upgrade at all, start with the signs your panel is asking for help.

Panel upgrade cost in Portland and Vancouver at a glance

Every job is quoted after we look at the panel, the meter, the service drop, and what you plan to plug in over the next ten years. But here are our own numbers for a typical single-family home in the Portland metro and Clark County, which most cost guides can't give you. Each one includes the permit and inspection, and they are the same prices we publish on our panel service page.

  • Panel replacement: $2,800 – $3,200. New panel and breakers in the same spot, grounding and bonding brought to code, every circuit labeled. This is the usual Federal Pacific or Zinsco swap.
  • Panel + 100A → 200A service upgrade: $5,100 – $6,800. New 200A panel and main, new service wires and meter socket, plus a new mast and weatherhead where the old ones are worn out.
  • Panel upgrade with relocation: from $7,700. The panel moves to a new spot, often outside, and every circuit is re-routed to it. Priced after a site visit.
  • Subpanel for a garage, shop or ADU: $1,000 – $1,500+. Priced mostly by the length of the feeder run and whether it has to be trenched.
  • 400A service for a large home, shop or several EVs: $7,000 – $12,000+. Heavier gear and utility coordination for the transformer.

Panel upgrade cost calculator

Pick the job and anything else you want done on the same visit. Panel replacement and the 200A upgrade are our current prices from our panel service page, permit and inspection included. The EV circuit comes from our own paid invoices, August 2024 to August 2026; the rest are planning estimates we price after seeing the house.

Estimate your panel or service upgrade

What's the main job?
Outside service: mast, weatherhead, meter base and grounding
Anything else on the same visit?

Get my written price

A planning tool, not a quote. Panel replacement and the 200A upgrade are our current prices (November 2026), permit and inspection included. The EV circuit comes from our own paid invoices, August 2024 – August 2026; the other rows are planning estimates. Your written estimate is free and replaces every number here.

What's actually included in a 200-amp service upgrade

"Panel upgrade" gets used for two different jobs. A panel replacement swaps the breaker box and keeps the existing service size. A service upgrade raises the amperage coming into the house, which touches everything between the utility's wires and your breakers. A proper 200-amp service upgrade in Portland or Vancouver should include all of the following, and your quote should list them:

  • New 200A load center and main breaker sized for the circuits you have now plus the ones you're adding (EV charger, heat pump, induction range, hot tub).
  • New meter socket, PGE-approved ring-style on the Oregon side, and a new service mast, weatherhead, and service-entrance conductors on an overhead service. PGE requires the meter socket and weatherhead to be brought up to current requirements whenever the service is upgraded.
  • Grounding and bonding brought to current code: ground rods or a connection to the footing rebar, water-pipe bond, and properly sized grounding electrode conductors. Older homes almost always need this.
  • An exterior emergency disconnect (required in Washington). Washington's rules call for an outdoor emergency disconnect whenever a one- or two-family service is replaced and the amperage changes or the meter base or mast moves, which is why most Clark County upgrades now use a meter-main combination. Oregon hasn't adopted that section, so in Portland it's a recommendation, not a requirement.
  • A whole-home surge protective device at the service. Washington requires one whenever dwelling service equipment is replaced; Oregon doesn't, but it's cheap insurance for every appliance, charger, and heat pump board in the house either way.
  • Breakers, labeling, and a directory that matches reality, including AFCI or GFCI breakers where you're adding or extending circuits.
  • Permit, inspection, and utility coordination, all scheduled by us, not you.

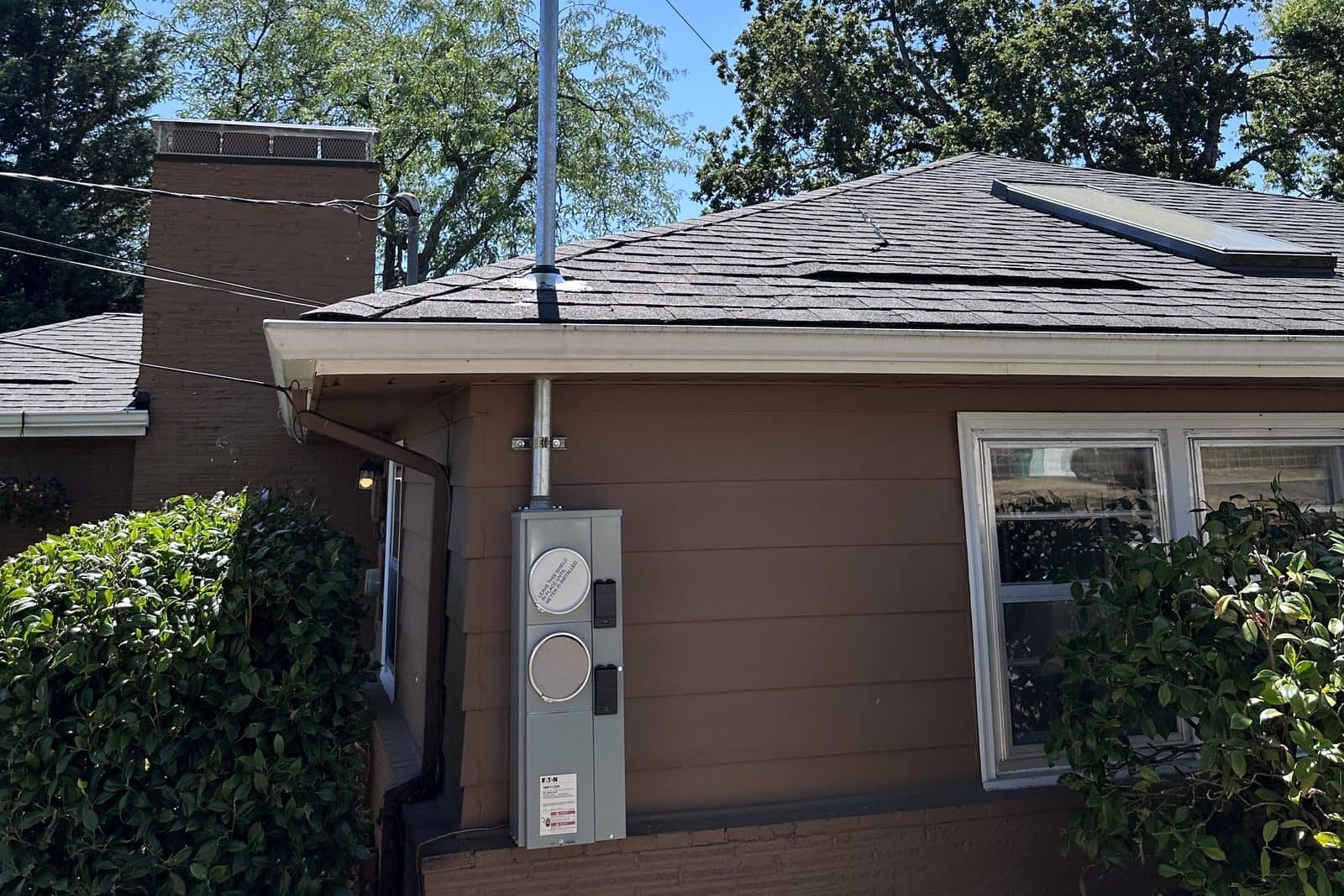

New service mast, weatherhead and meter base installed on a Portland-area home during a 200-amp service upgrade
A full service upgrade rebuilds the mast, weatherhead and meter base, not just the panel inside. This is the part a "panel-only" quote leaves out.

The 7 things that move the price

Two houses on the same street can get quotes $3,000 apart and both be fair. Here's what an electrician is pricing when they look at your setup:

  1. Service size and panel capacity. Going from 100A to 200A is the common move; 400A needs heavier gear and more utility involvement. Circuit count matters too, since a 40-space panel leaves room for the next decade.
  2. Meter base, mast, and service-entrance condition. If the mast is rusted, the weatherhead is sagging, or the meter socket is an obsolete style, they get replaced. Underground services skip the mast but can involve trenching or a utility-side conductor change.
  3. Grounding and bonding updates. Most pre-1990 homes are missing something here. It's not optional, and it's not expensive, but it's work.
  4. Panel location and access. An open garage wall is a half-day job. A panel buried in a finished basement closet, behind lath and plaster, or in a location code no longer allows (bathrooms, clothes closets, over stairs) can turn into a two-day job with a relocation.
  5. Breaker requirements. Oregon's electrical code specifically says replacing or upgrading a service or panelboard does not force existing circuits onto AFCI breakers, which keeps a simple swap affordable. New or extended circuits still need AFCI/GFCI protection in both states.
  6. The utility side. PGE, Pacific Power, and Clark Public Utilities each have their own approval and scheduling steps. In older parts of Portland, a jump to 200A or 400A can trigger a transformer or service-drop evaluation that adds time more than money.
  7. Surprises behind the cover. Double-tapped breakers, aluminum branch circuits, knob-and-tube splices, or scorching all get flagged during the estimate visit. That's the reason we look before we quote. If you own a pre-1950 or late-1960s home, our guide to knob-and-tube and aluminum wiring covers what those findings mean.

Permit fees: Portland vs. Vancouver and Clark County

A panel or service upgrade needs an electrical permit and a final inspection in both states, and the permit has to be pulled by a licensed electrical contractor (or, in limited cases, the owner-occupant). The fee itself is a small line item, but the jurisdiction determines who inspects and how fast:

Residential service permit, 200 amps or less
Where the house isWho issues and inspectsService permit feeNotes
Inside Portland city limitsPortland Permitting & Development$212 for 200A or less; $298 for 201–400A (schedule effective July 10, 2026)Plus the 12% Oregon state surcharge (about $237 for 200A) and $21 per added circuit
Beaverton, Hillsboro, Gresham, Tigard, Clackamas County, etc.That city or county's building departmentVaries; unincorporated Washington County is $236 for 200A or lessSame Oregon Electrical Specialty Code, different counter and inspector
Inside Vancouver city limitsCity of Vancouver electrical program$88.20 for a 0–200A residential service with feeder (2026 city fee sheet)Clark Public Utilities still controls the meter
Camas, Washougal, Battle Ground, Ridgefield, unincorporated Clark CountyWashington Dept. of Labor & Industries$109.90 for an altered service, 0–200A; $161.00 for 201–600A (fees effective July 1, 2026)L&I inspector signs off before the utility reconnects

We pull the permit, schedule the inspection, and show the fee as its own line on the estimate. If a quote you're comparing doesn't mention a permit at all, ask. Unpermitted panel work is one of the most common things a home inspector flags at resale, and fixing it later costs more than doing it right once.

Fee figures updated September 30, 2026. An earlier version of this page listed Portland at $239 — that is the city's fee for a manufactured or modular home, not a service change — and used L&I's 2025 fees. For the step-by-step on applying, inspections and the utility reconnect, see our panel upgrade permit guide.

Utility coordination: PGE, Pacific Power, and Clark Public Utilities

The utility owns everything up to the meter and has to be involved in any service upgrade. This is the step homeowners most often don't expect, and it's where most of the calendar time goes.

Portland General Electric (most of the Portland metro). PGE requires prior notice before you add load or modify service equipment, so we open the request with PGE Service Coordination before the install day, not after. PGE will only reconnect once the city or county inspector has approved the work, and they want the meter socket and weatherhead brought to current standards as part of the upgrade. In some older neighborhoods, a 200A or 400A request triggers a look at the transformer serving your block, which can add a week or two.

Pacific Power (parts of the metro and the Oregon coast). Same idea: notify first, install, inspect, reconnect. Pacific Power's home EV charger rebates for income-qualified customers can also help offset a 240V circuit or charger install done at the same time.

Clark Public Utilities (Vancouver and Clark County). Only Clark PUD personnel may pull the meter, so the sequence is fixed: permit posted, CPU removes the meter, we do the work, the city or L&I inspector signs off, CPU reinstalls the meter and restores power. CPU asks that the work be scheduled through their Construction Services line with a project number, which we handle. Your house is without power for the working part of the day.

How long does a panel upgrade take?

The install itself is one working day. The calendar around it is what you should plan for:

  1. Estimate visit (about an hour). We photograph the panel and meter, do a load calculation, and confirm what you're planning to add.
  2. Permit filed (usually a few business days). Online through Portland Permitting & Development or Washington L&I; some suburban jurisdictions take a little longer.
  3. Utility scheduling (1–3 weeks). The PGE or Clark PUD appointment usually sets the install date.
  4. Install day (4–8 hours). Power is off for most of it. Plan for the fridge, medical equipment, and home office accordingly; we'll tell you the window in advance.
  5. Inspection and reconnect (same day to a few days). The inspector approves, the utility restores or re-energizes the service, and you get a labeled panel and the permit paperwork for your records and insurer.

Three to four weeks from first call to final inspection is typical for a planned upgrade. A panel that has failed or burned is a different conversation: we treat it as an emergency call, get temporary power sorted, and expedite the permit and utility steps. This fire-damaged panel and meter replacement in Vancouver shows what that looks like.

Signs your panel is asking for an upgrade

The warning signs usually show up well before anything fails. Any one of these is worth a professional look; two or more together mean the panel has become the limiting factor in the house.

  • Breakers that trip repeatedly on the same circuit, or a main breaker that trips when two large appliances run at once.
  • A panel that is warm to the touch, a burning or fishy smell near it, or scorch marks around a breaker — stop and call us; that one is not a scheduling question.
  • Lights that dim when the dryer, oven or heat pump kicks on.
  • A fuse box, a 60-amp or 100-amp service in a house that now has an EV, a heat pump or an induction range, or no free slots left in the panel.
  • A Federal Pacific Stab-Lok or Zinsco label — see the insurance section below; inspectors in Portland and Vancouver flag both.

If you are seeing any of these, a licensed electrician can assess the panel and the service size and tell you which of the options below actually applies — often it is a cheaper one than a full upgrade.

Do you actually need a bigger service? Sometimes the answer is no.

A 100-amp service is enough for a lot of homes, and we'd rather do a load calculation than sell you amperage you won't use. The honest triggers for going to 200A are an EV charger on a 40–60A circuit, a heat pump or ductless system replacing gas, an induction range, a hot tub, or an ADU, especially in combination.

When the panel is sound but full, a subpanel solves the space problem for a fraction of a service upgrade. When the service is tight but not over, a smart panel or a load-managed EV charger can throttle the charger when the dryer and oven are running, and keep you under your existing service without a utility upgrade at all. We installed the smart panel below alongside a whole-home battery and a Tesla charger in Vancouver; the homeowner got backup power and Level 2 charging without touching the service size.

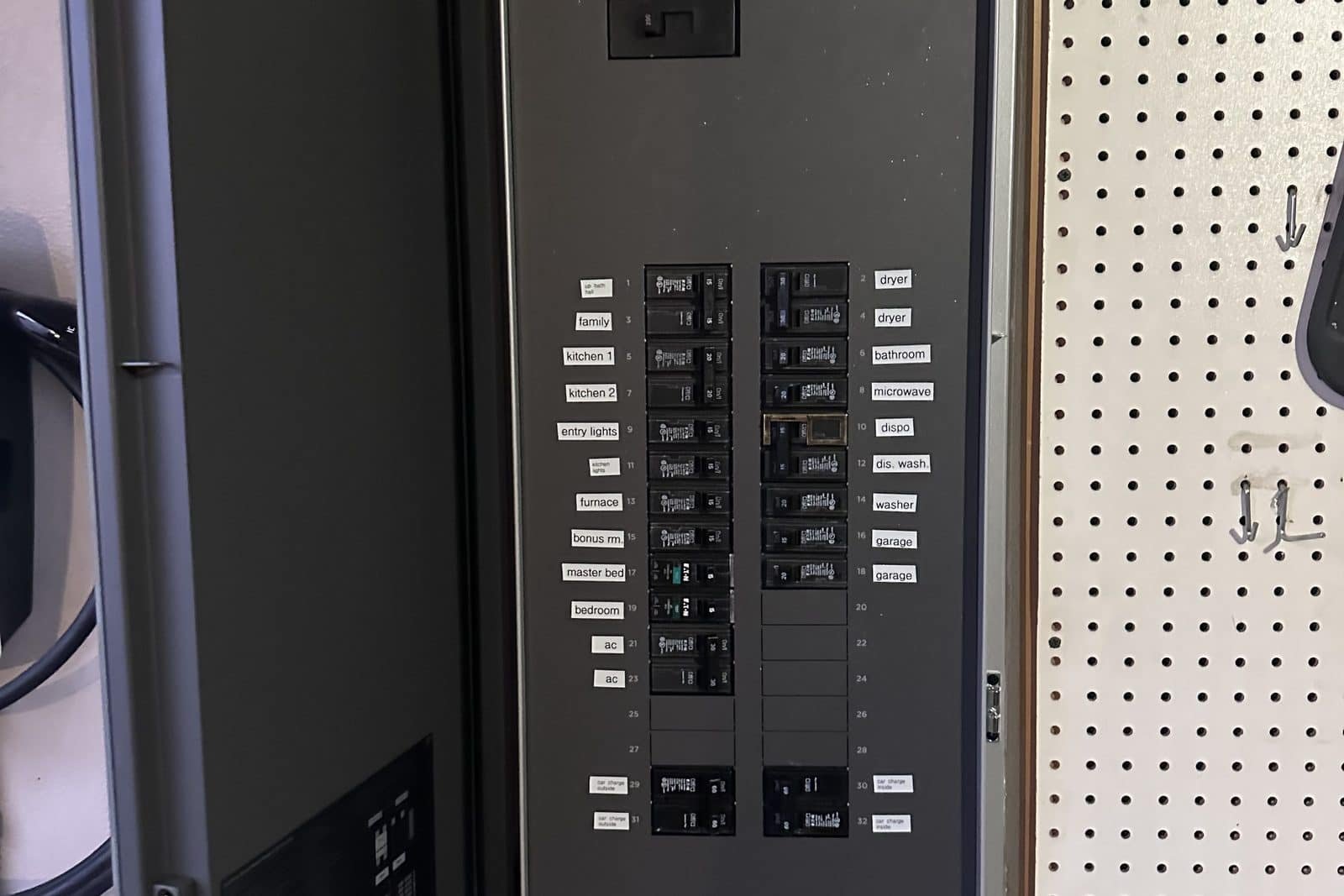

EcoFlow smart electrical panel with labeled household circuits installed by Power Professor in Vancouver, WA
A smart panel with load management, installed in Vancouver, WA. Circuit-level control can postpone a service upgrade for some homes, but not all. See the full project.

Ways to keep the cost down, and what not to skimp on

A few decisions make a real difference to the final number:

  • Bundle the circuits you know you'll need. Adding the EV charger, hot tub, or shop circuit on the same visit means one permit, one utility appointment, and one trip charge. Pricing a Level 2 charger circuit with the upgrade is almost always cheaper than coming back for it next spring.
  • Keep the panel where it is if code allows. Relocation is the single biggest optional cost.
  • Plan it, don't wait for it to fail. An emergency replacement after a burnt main or a failed meter base happens on the utility's schedule and often in the rain. A planned upgrade happens on yours.
  • Ask for an itemized quote and compare like with like: service size, meter base, grounding, surge protection, permit, and patching should each be visible.

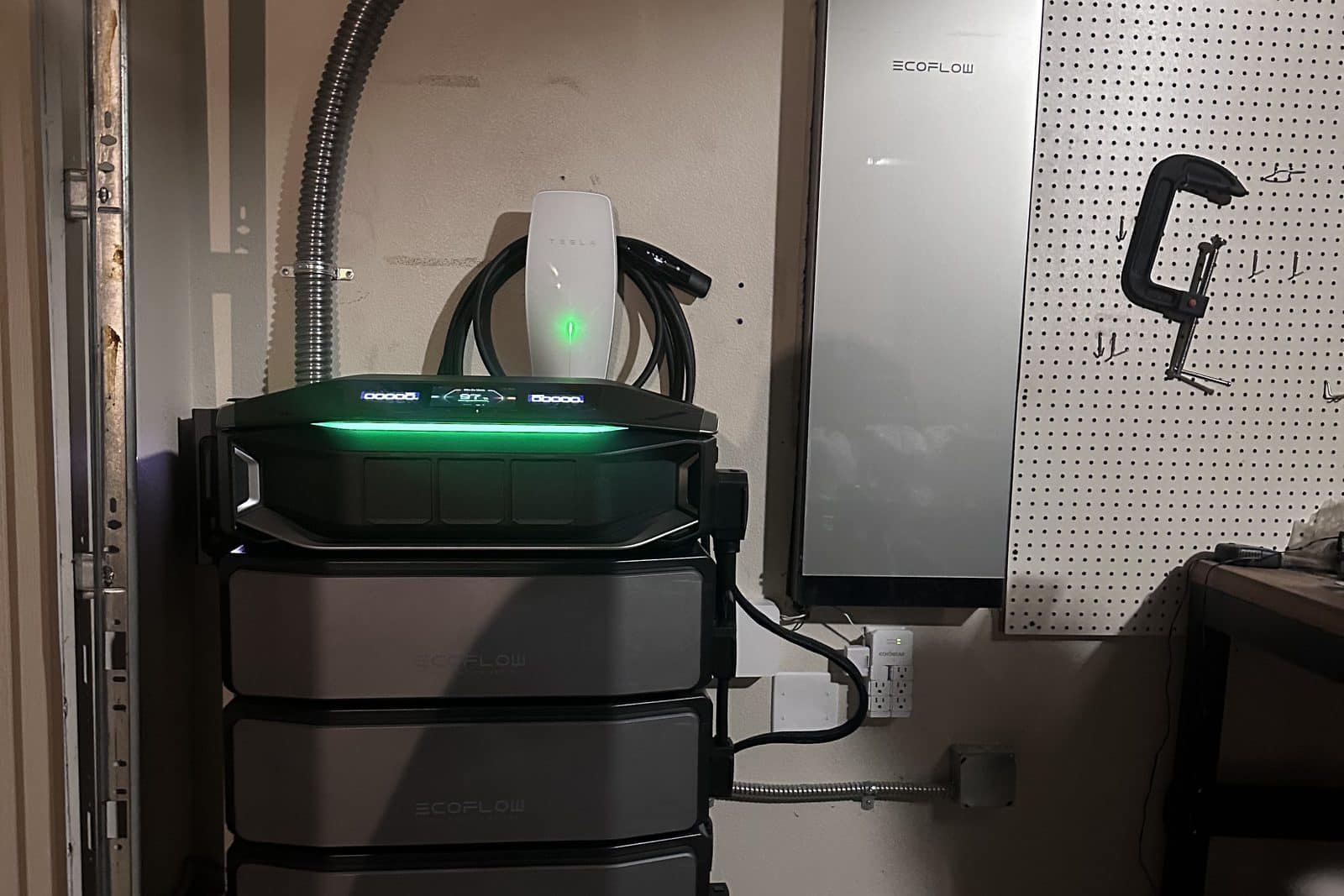

Whole-home battery backup system and Tesla Level 2 EV charger in a Vancouver, WA garage, installed by Power Professor
EV chargers, batteries, and heat pumps are the reason most 2026 panel upgrades happen. Pricing them together with the upgrade is the cheapest way to do it.

What not to cut: the permit, the grounding work, the surge protector, and the labeled directory. None of them are where the money is, and all four are what an inspector, an insurer, or the next buyer will look for first.

Insurance, Federal Pacific, and Zinsco panels

If your insurer or home inspector has flagged a Federal Pacific Stab-Lok or Zinsco panel, the replacement usually falls in the panel replacement or 200A upgrade ranges above (a typical FPE or Zinsco swap runs $2,800 – $3,200 with us, permit included), and we provide the permit and inspection documentation your carrier asks for. Both brands have a long record of breakers that fail to trip under fault conditions, and many insurers in Oregon and Washington treat replacing them as a condition of coverage rather than a suggestion. Our Federal Pacific and Zinsco replacement page covers what we replace them with and what the process looks like.

Whether you're in Portland, Beaverton, Gresham, Vancouver, or Camas, the same licensed crew (Oregon CCB #244602, Washington POWERPL813L6) handles the estimate, the permit, the utility coordination, and the inspection.

Answers

Frequently asked questions

01How much does it cost to upgrade from 100 to 200 amps in Portland?
With us, replacing the panel and upgrading the service from 100 to 200 amps costs $5,100 – $6,800: a new 200A panel and main breaker, new service wires and meter socket, utility coordination, permit and inspection. If the panel also moves to a new spot, it starts around $7,700. A written estimate after a site visit is the only number worth budgeting on.
02Is a panel upgrade cheaper in Vancouver, WA than in Portland?
Labor and materials are similar across the metro. The permit is a little cheaper in Washington: $109.90 through L&I or $88.20 inside Vancouver city limits for a 0–200A service, against $212 plus Oregon's 12% surcharge inside Portland. Clark Public Utilities' meter-pull process is also predictable. The government fee difference is only about $130 to $150; overall the two sides usually land within a few hundred dollars of each other.
03Do I need a permit to replace my electrical panel?
Yes, in both Oregon and Washington. A licensed electrical contractor pulls the permit and schedules the inspection; the utility won't reconnect a service without the inspector's approval. We include the permit in every panel quote.
04How long will my power be off during the upgrade?
Plan on most of one working day, typically 4–8 hours. In Oregon, power usually comes back the same day: a licensed supervising electrician can ask the utility to reconnect before the inspection, which follows within a few days. In Clark County, Clark Public Utilities restores power after the inspector signs off. We'll give you the window ahead of time so you can plan for refrigeration, medical equipment, and work-from-home needs.
05Will PGE or Clark Public Utilities charge me for the upgrade?
A standard like-for-like reconnect usually carries no separate utility charge, but if your upgrade requires a new service drop, a larger transformer, or underground conductor work, the utility may quote that portion separately under its tariff. We flag that possibility during the estimate so it never shows up as a surprise.
06Is 200 amps enough for an EV charger and a heat pump?
For most single-family homes, yes. A 200A service comfortably supports a Level 2 charger on a 40–60A circuit plus a heat pump, range, and dryer. Homes adding two chargers, a large shop, or an ADU are the usual candidates for 400A, and a load calculation tells us which side of the line you're on.
07Can I just replace the breakers instead of the whole panel?
If the panel is a sound, current brand with available replacement breakers, sometimes. If it's a Federal Pacific, Zinsco, or another obsolete panel, replacement breakers either aren't available or don't fix the underlying design problem, and the panel itself should go.
08Does a panel upgrade add value when I sell?
It removes one of the most common inspection-report deal-breakers and answers the buyer's EV and heat pump questions before they ask. A permitted, labeled 200A service with documentation is something appraisers and buyers both recognize.
09How much does it cost to upgrade an electrical panel from 150 to 200 amps?
About the same as from 100 to 200 amps, because the parts and labor are the same: new meter base or meter-main, 200 amp service conductors and panel, grounding brought to code. Our current price for that job is $5,100 to $6,800, permit and inspection included. Before paying for it, have a load calculation done; a 150 amp service often has room for a heat pump or EV charger.
10Can I replace a 150 amp panel with a 200 amp panel?
Yes, but on its own it stays a 150 amp service. A panel rated 200 amps can be installed on a 150 amp service with a 150 amp main, and the house is still limited to 150 amps. To get 200 amps of capacity, the meter base and service conductors are upgraded too, and the utility confirms its drop and transformer can serve 200 amps.
11Can I upgrade my electrical panel without rewiring my house?
Yes, in almost every case. A panel or service upgrade replaces the meter base, service conductors, panel and breakers, and reconnects the existing branch circuits to the new panel. The house wiring stays. Exceptions are circuits too short to reach a relocated panel, which get spliced or extended, and old knob-and-tube or damaged wiring, which is a separate decision.
12How much do electricians charge for a panel upgrade in Portland?
Our current prices are $2,800 to $3,200 for a panel replacement and $5,100 to $6,800 for a panel plus 200 amp service upgrade, permit and inspection included. Quotes from different electricians vary mostly with what they include, so compare the meter socket, service wires, grounding, surge protection and permit line by line. Use the calculator above for your combination.
